Notable Features |
|
Semi precast
slab and beams |
|
Precast
staircases |
|
Composite
columns with steel formwork |
|
Aluminum and
steel formwork |
|
Hardiwall
partitions |
|
Use of jump
lift |
|
Reusable
safety system |
|
|
Basic Information |
Location: |
Taikoo Place, 979
King's Road,
Quarry Bay, Hong Kong |
Building Type : |
Office |
Contract
Period: |
29/10/2001 -
21/04/2003 (540 days) |
Contract Sum : |
Approximately HK$420
million |
Site Area : |
6,700 sqft |
Gross Floor Area : |
Total construction floor area:31,140 m2 |
Typical Floor Area
: |
795 m2 |
Client : |
Taikoo Place Holdings Ltd. |
Client's Project
Manager : |
Swire Properties Ltd. |
Architect : |
Wong & Ouyang (HK) Ltd. |
Structural
Engineer : |
Maunsell Structural Consultants Ltd. |
E&M Consultant : |
Meinhardt (M&E) Ltd. |
Quantity Surveyor
: |
Levett & Bailey Chartered Quantity
Surveyors Ltd. |
Main Contractor : |
Hsin Chong Construction (Asia) Ltd. |
|
. |
Overview |
This
36-storey grade A office building includes a 2-storey podium and a 1-storey M/E
floor. The total construction floor area is 31,140m2, and each typical floor
area is 795m2. Typical floors construction (4 days cycle) is split into two
portions: semi-precast portion and in-situ portion. The in-situ portion is two
floors ahead the precast portion. 95% BS Components off-site prefabricated. |
|
|
|
Precast
portion: |
|
Precast floor
from 3/F to 21/F: 11 beams, 44 planks, and 3 stair modules per floor. |
|
Precast floor
from 22/F to 36/F: 12 beams, 48 planks, and 3 stair modules per floor. |
|
|
|
In this
project, the choice for precast construction method is due to its lower cost and
shorter construction period. Although the technology used is more expensive than
traditional methods, the total cost is lower because of the shorter construction
period. The in situ methods would have extended the construction for 2 months. |
|
|
|
.
|
Typical Floors Construction
(4 days cycle) |
|
|
|
|
|
|
Semi-precast Planks |
|
|
Semi-precast
planks are delivered on site on Day 2, and hoisted and installed on Day 3. The
plank dimensions are: max. Span 2.4 x 4.9 m2, and the max. Weight: 3.1 tons |
|
|
|
|
|
|
|
|
|
|
|
Semi-precast
Beams |
Semi-precast
beams are delivered on site on Day 2, and hoisted and installed on Day 3. The
beam dimensions are: max Span 16 m, 575 mm depth, and max. Weight 10 tons. |
|
|
|
|
Precast Staircases |
Precast
staircases are hoisted and installed on Day 1. The staircase dimensions are: max
span: 6.9 m, and max. Weight 10.8 tons. |
|
|
|
|

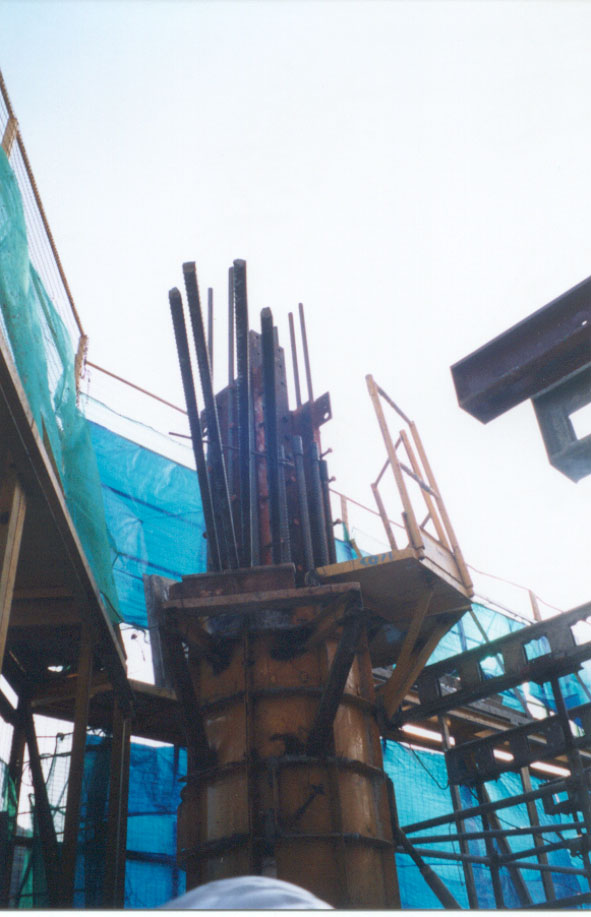

Columns |
Steel fixing
of columns, installation of steel column formworks and concreting (22m3) are
done on Day 2. |
|
|
|
|
Aluminum and Steel Formworks |
|
|
|
Aluminum and
steel formworks are used for the in-situ portion. Refer to the typical floors
construction (4 days cycle) table for details. |
|
|
|
|
Hardiwall |
Hardiwall
system is used for internal partition. |
|
|
|
|
Jump Lift |
Definition:
Using constructed lift shafts and permanent lift components to provide builder’s
lift services during construction stage. |
|
Advantages: |
-
Safety, as builder’s lift is located inside lift shaft and not
outside.
-
Noise reduction, minimizing disturbance to neighborhood.
-
Accelerating internal finishing and installation works.
-
Avoiding deferred works to external wall finishing.
|
Characteristics |
|
|
Cost difference of builder’s works:
Cost (A) – Cost (B) = $89,500
1 jump lift cost around $450,000, additional cost for using 1 jump
lift:
$450,000 + $89,500 = $539,500 |
|
Reusable
Safety Systems |
All the safety
systems are reusable and easy to assemble:
|
|
|
Contact of
Contractor |
Hsin Chong Construction Co.
Ltd.
8/F Hsin Chong Center
107-109 Wai Yip Street
Kwun Tong, Kowloon
Hong Kong
www.hsinchong.com |
|
|
|
